Client: Vietnam Waste Solutions, Inc.
Main Contractor: JPS Engineering & Construction Company Limited
Project Details:

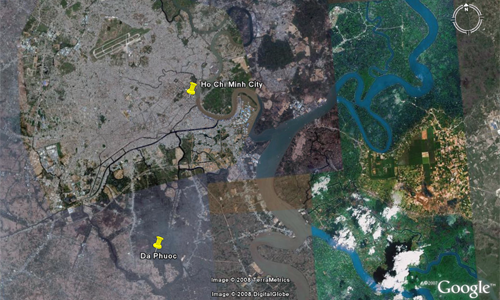

Da Phuoc Integrated Waste Management Facility is located in Da Phuoc Commune, Binh Chanh District ~ south of Ho Chi Minh City, Vietnam.
Da Phuoc Phase 1 Sanitary Landfill with leachate collection, removal & treatment is designed by Vector Engineering Inc. basing on North American standards and receives up to 6,000 tons of domestic waste daily.
Green Cosmos jointly with our local partner JPS E&C constructed the entire 45ha landfill complete with soil improvement works (PVD), field installation of 1.5mm thick single-side textured HDPE liner and 30/30 kN biaxial geogrids, sub-drain & leachate collection system and uni-axial high strength geogrid reinforced embankment construction – all under strict CQA supervision by Vector Engineering, Inc.
Approximate Quantities
Sub-drain sand : 400,000 cum PVD : 1,180,000 linm Sub-drain pipes : 3,800 linm Biaxial geogrid : 310,000 sqm |
Engineered Fill : 90,000 cum Biaxial geogrid : 310,000 sqm Strip drain : 67,000 linm |
HDPE Liner : 310,000 sqm LCRS Sand : 31,000 cum LCRS pipes : 17,000 linm |
Pictorials on Landfill Construction & Field Installation of Environmental Lining System:
![]() Location |

![]() Access by water |

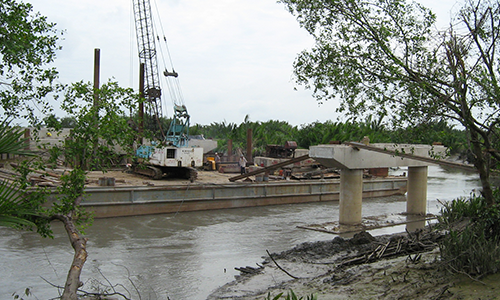

![]() Bridge construction |

![]() Completed bridge |
![]() Clearing of mangroves |

![]() Pumping sand |
![]() Sand pumped into place |

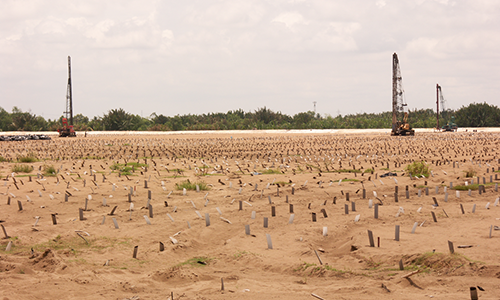

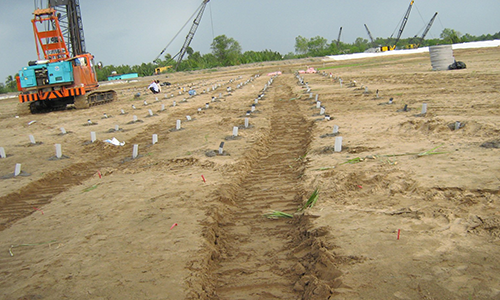

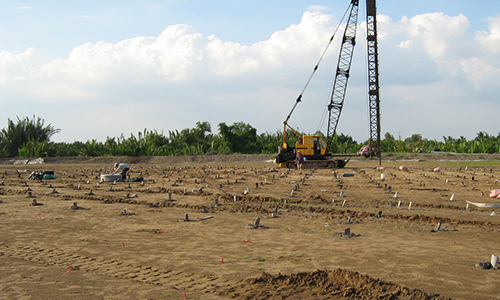

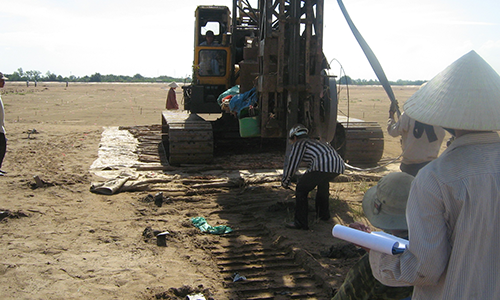

![]() Prefabricated vertical drains |

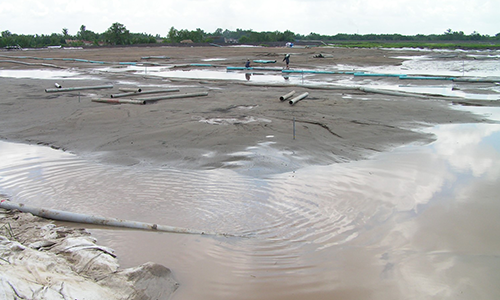

![]() Soft sand |

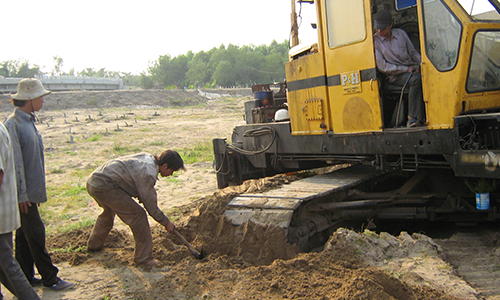

![]() Machine bogged |
![]() Timber platform |

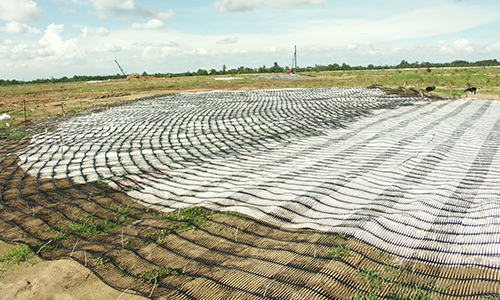

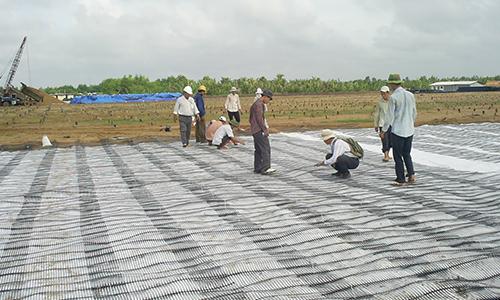

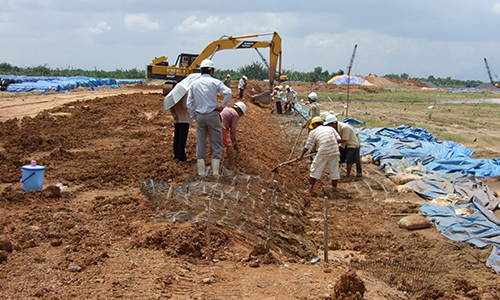

![]() Geogrid for worst areas |

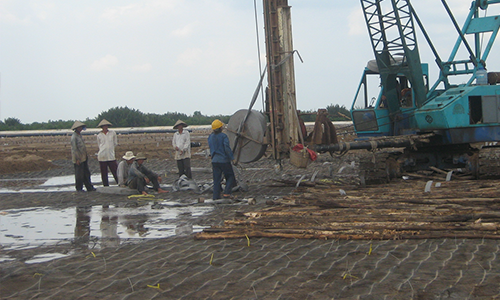

![]() PVDs |

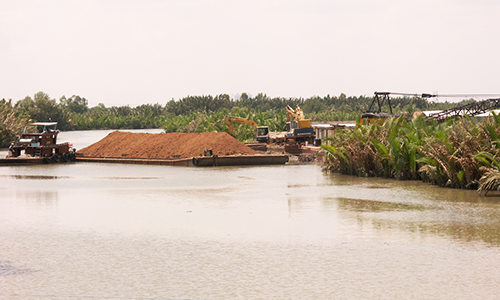

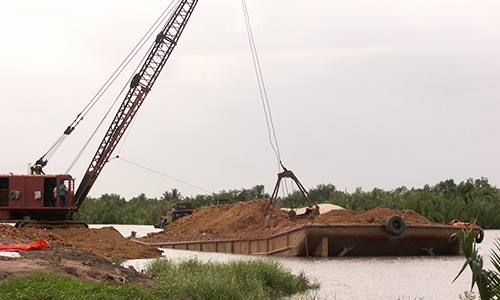

![]() Materials by barge |
![]() Clamshells to unload |

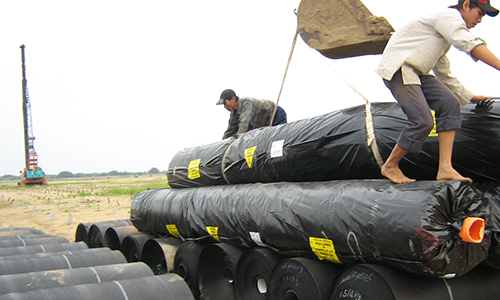

![]() Stacking geosynthetics |

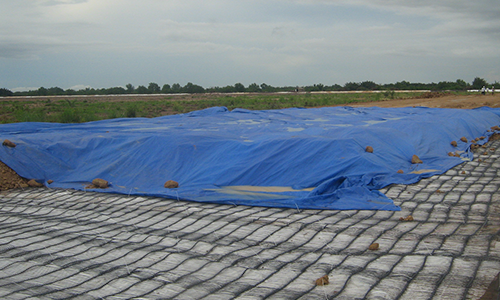

![]() Covering geosynthetics |
![]() Geogrid and geotextile for embankments |
![]() Geogrid around corner |

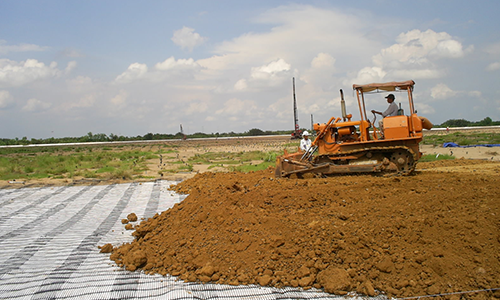

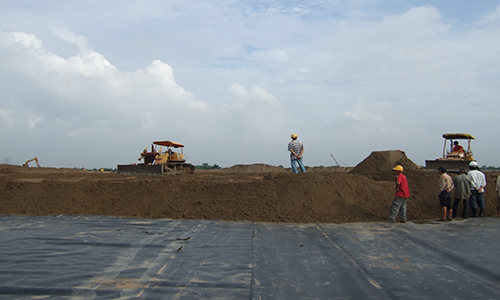

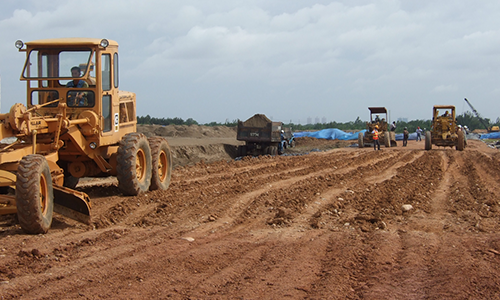

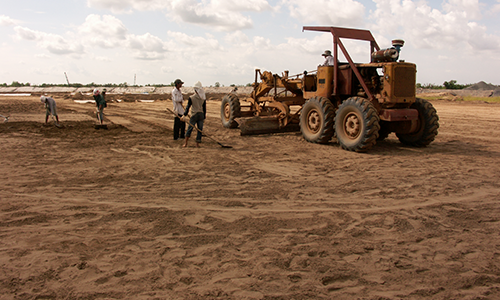

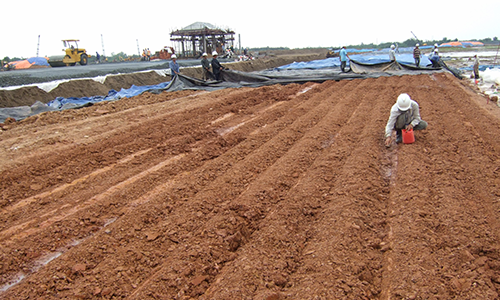

![]() Spreading of Fill |

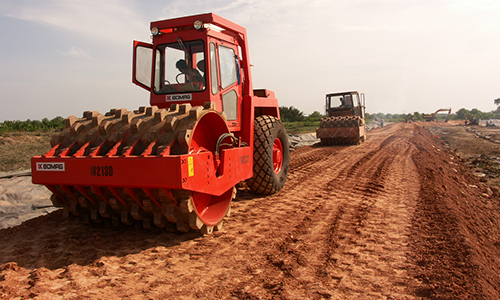

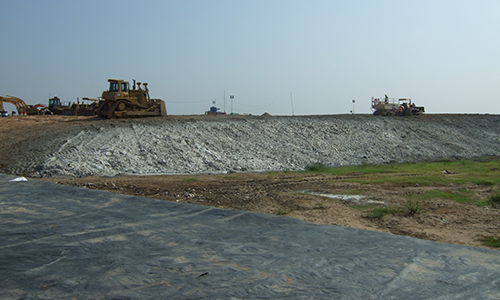

![]() Compaction of fill |

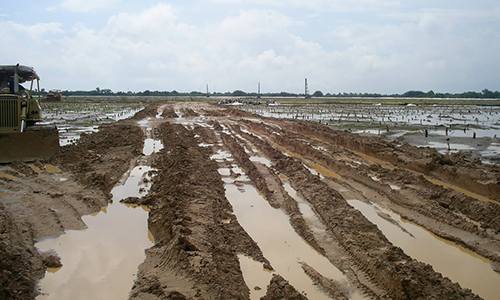

![]() Wet Season |

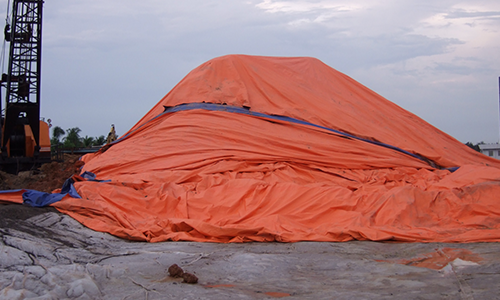

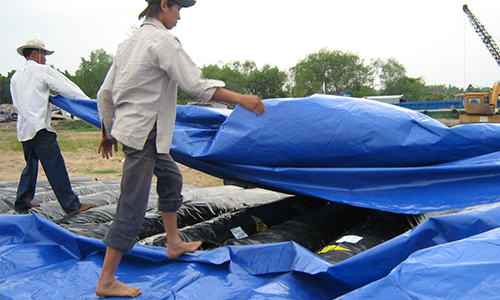

![]() Cover for fill |
![]() Cover for stockpiles |
![]() Deploying earthfill cover |
![]() Re-working of fill |
![]() More re-working of fill |

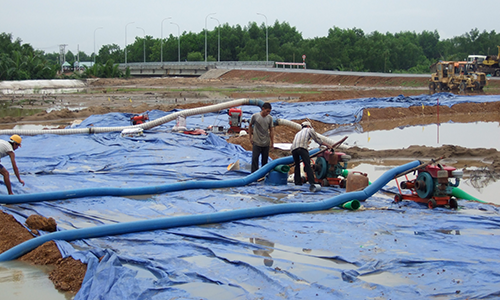

![]() Pumps and more pumps |

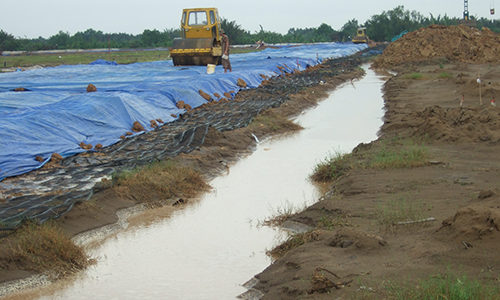

![]() Drainage channels |

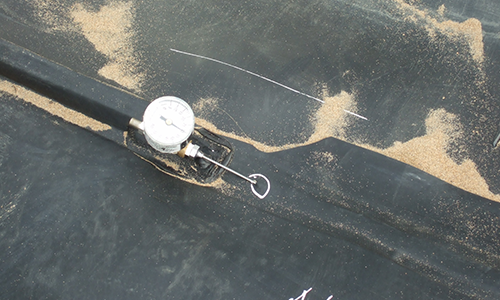

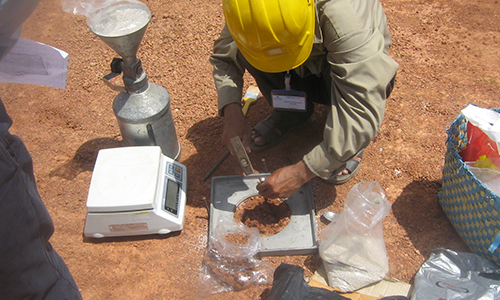

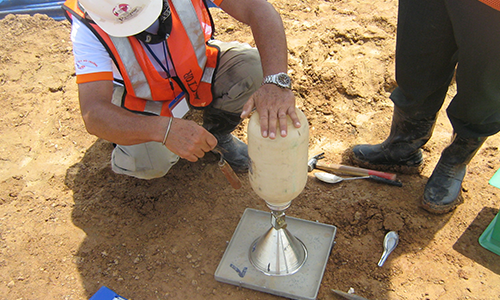

![]() Density by sand replacement |
![]() Sand cone |
![]() Geogrid wrapping at toe |

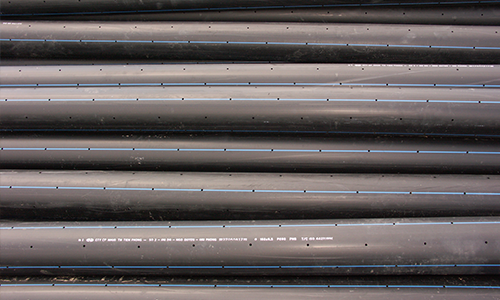

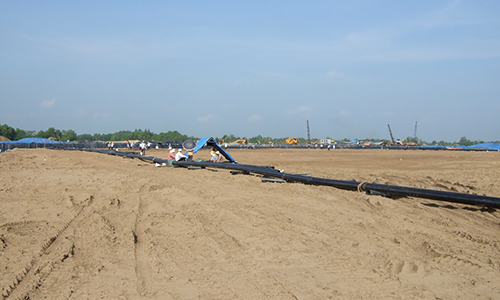

![]() Perforated pipes |

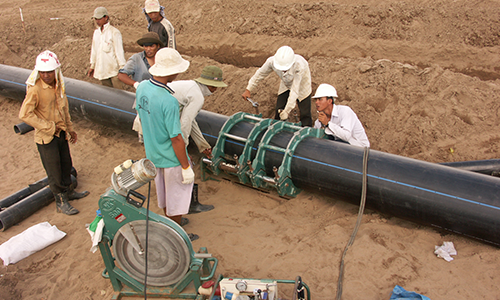

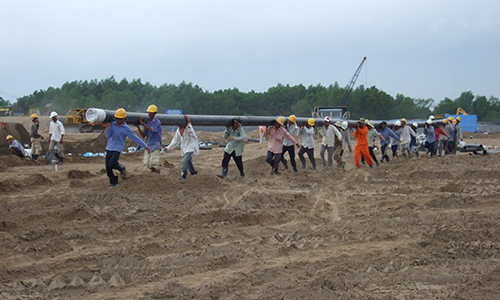

![]() Butt welding pipes |

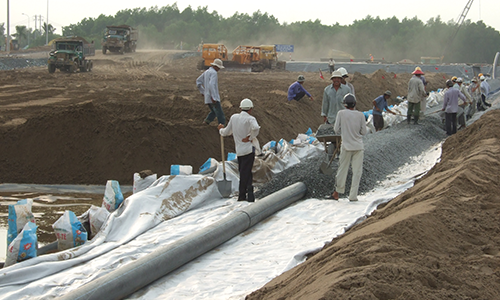

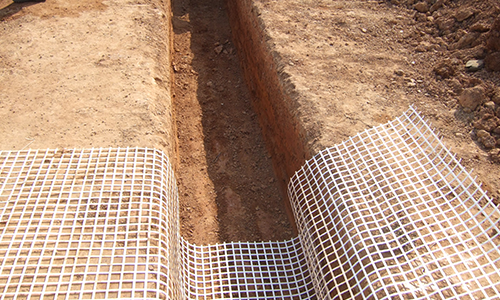

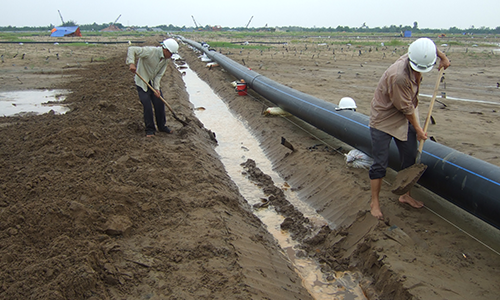

![]() Trenching for sub-drain pipes |
![]() Sub-drain pipe installation |
![]() Clearing vegetation |

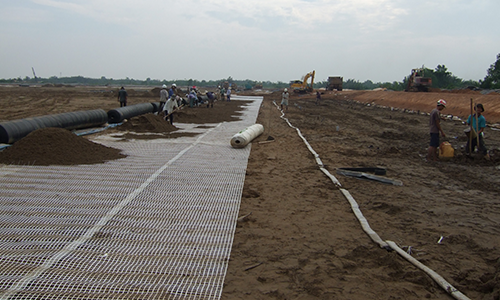

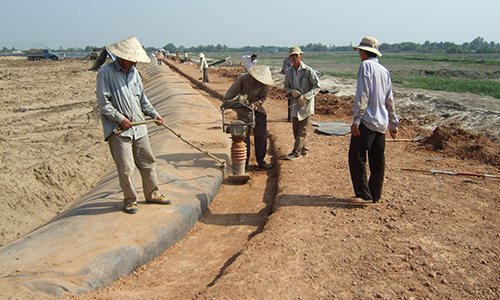

![]() Biaxial geogrid and strip drains |
![]() Stripdrain and PVD |
![]() Sand cover |
![]() Compaction of face |
![]() Anchor trench |
![]() Backfill anchor trench |
![]() Subgrade preparation |

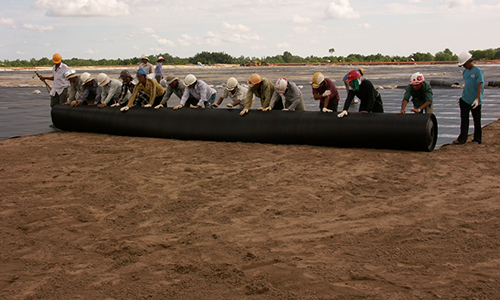

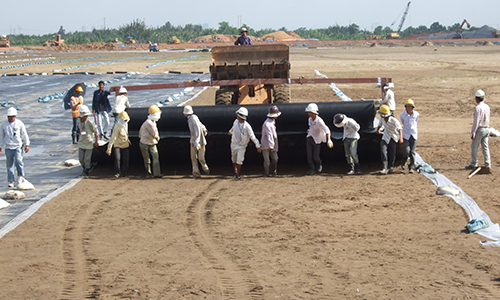

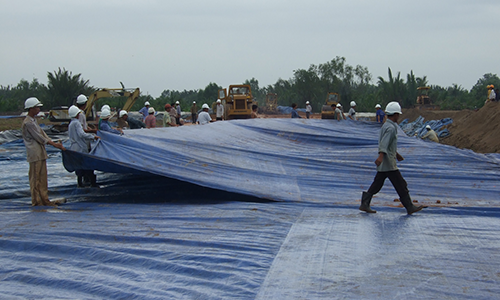

![]() Deploy liner |
![]() Deploy liner |

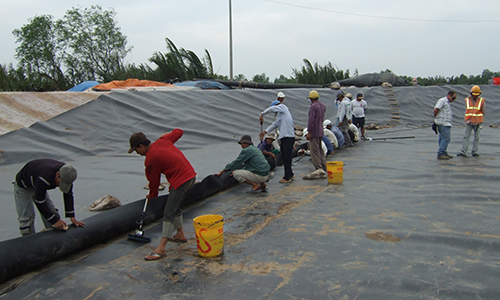

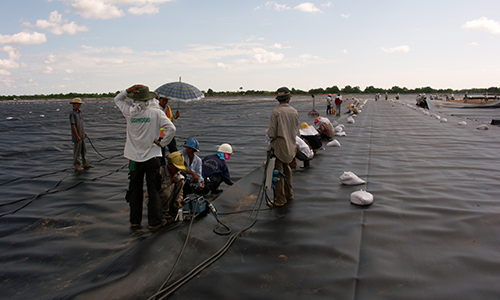

![]() Cleaning for seams |
![]() Seaming crew |

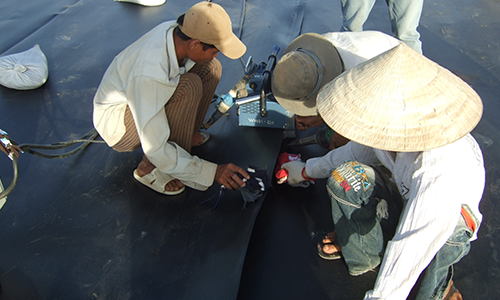

![]() Seaming |

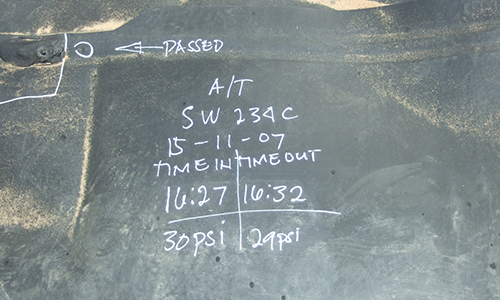

![]() Air pressure testing |
![]() Testing passed |

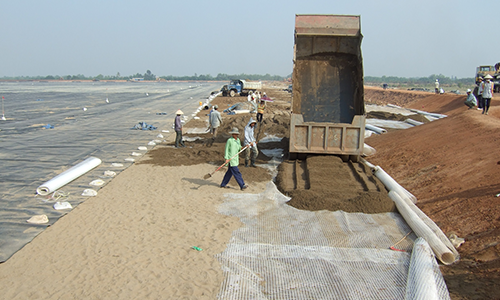

![]() Leachate sand placement |
![]() More leachate sand |
![]() Leachate pipes |
![]() Adapt local methods |
![]() Leachate pipe installation |
![]() Placement of waste |
![]() And it all went without a hitch! |
